  • We care for your asset

58 KM Mining Hauling Road

SCOPE OF WORK

Gravel with Laterite Red Soil for Hauling Road Purposes – General Requirements
  • Compliance with all relevant local and international standards for road construction.
  • Adherence to pavement design parameters as outlined below.
  • Quality assurance through on-site testing (CBR, compaction, material gradation).
  • Environmental protection and safe working practices throughout construction.
Pavement Design Criteria
  • Design Load: 40-tonne dump trucks (gross vehicle weight)
  • Road Width: 8–12 meters
  • Total Pavement Thickness: 30 cm
  • Design Method: CBR curve method (Atkinson, 1992)
  • Pavement Layers
  • Subgrade: In-situ soil with CBR < 6%
  • Base Course: Gravel C(7/10)
  • Surface Course: Gravel B(2/3)

Detailed Work Breakdown

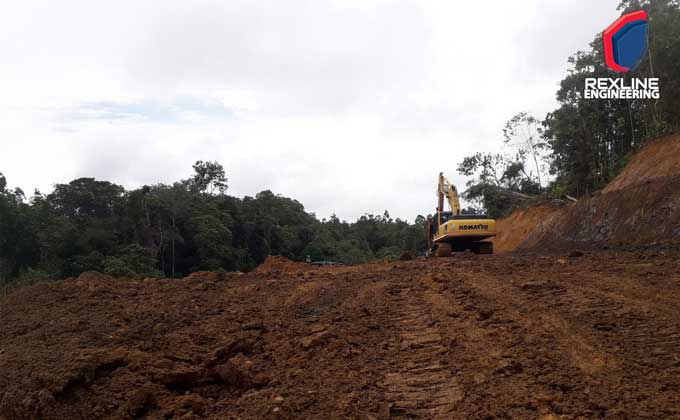

1.1. Site Preparation
  • Clearing and Grubbing: Removal of vegetation, roots, stumps, debris, and organic material from the alignment.
  • Stripping Topsoil: Remove unsuitable topsoil to expose the subgrade.
  • Earthworks: Cut and fill operations to achieve the desired road profile and camber. Ensure drainage cross fall/camber of approximately 3% to prevent water stagnation.
1.2. Subgrade Preparation
  • Subgrade Evaluation: Conduct field CBR testing to confirm strength < 6%.
  • Compaction: Compact subgrade to 95% Modified Proctor Density (MPD).
  • Stabilization (if required): Use lime, cement, or geotextile/geogrid in areas with extremely weak subgrade.
1.3. Base Course Layer (Gravel C(7/10))
  • Material Requirements: Gravel with gradation C(7/10), conforming to project specifications.
  • Layer Thickness: Lay to appropriate thickness (typically 20 cm out of total 30 cm if not otherwise split).
  • Placement and Compaction: Place evenly with motor grader.
  • Compact in layers using vibratory rollers to 98% MPD.
  • Moisture Conditioning: Ensure optimal moisture content during compaction.
1.4. Surface Course Layer (Gravel B(2/3))
  • Material Requirements: Hard, angular gravel with gradation B(2/3) for wear resistance and skid resistance.
  • Layer Thickness: Apply remaining pavement thickness (typically 10 cm).
  • Placement and Finishing: Place with motor grader for uniform thickness.
  • Compact with steel drum roller.
  • Ensure final camber for water runoff (typically 3–5%).
1.5. Drainage System
  • Side Drains: Excavate trapezoidal side drains or construct lined V-drains to prevent water pooling.
  • Culverts and Cross Drains: Install at low points or crossings to maintain natural water flow.
  • Ensure drainage cross fall/camber of approximately 3% to prevent water stagnation.
1.6. Road Geometry and Safety
  • Horizontal Alignment: Maintain safe turning radius for 40T trucks.
  • Vertical Alignment: Design to accommodate acceptable grades (ideally less than 8% for haul trucks).
  • Signage and Delineation: Install temporary or permanent markers, signs, and reflectors as required.
1.7. Quality Control & Testing
  • Material Testing: Gradation test (sieve analysis), Atterberg limits, compaction test (Proctor), and CBR.
  • Field Density Testing: Sand cone or nuclear gauge for in-situ compaction verification.
  • Level and Thickness Surveys: Conduct using total station or GPS equipment.
1.8. Maintenance and Defect Liability
  • Initial Maintenance Period: Address rutting, potholes, and erosion during the early use period.
  • Defect Monitoring: Regular inspection and repair during the defect liability period.
2. Deliverables
  • Site plan showing alignment and drainage
  • Daily progress reports and QC records
  • As-built drawings and compaction test reports
  • Material source approvals and gradation certificates
